Digital Twin Platform

Research Internship · 18-Week Gantt Project Plan

Duration18 weeks BasisThesis / research collaboration HostGraha International GmbH
↓  Download the 18-week plan (PDF) ↓  Download as Word document (DOCX)

Overview

This internship contributes to Graha International's research on onboard and offboard predictive applications for connected vehicles. The intern designs and prototypes a Digital Twin platform that maintains a live, synchronised virtual representation of a vehicle subsystem and supports simulation, monitoring and what-if analysis.

Structured as an 18-week Gantt Project Plan, the work is suitable as the practical basis for a Bachelor's or Master's thesis or a research collaboration. It emphasises real-time data fusion, model fidelity and the link between digital twins and predictive maintenance.

Objectives

Candidate Profile

18-Week Gantt Project Plan

The plan is organised into six best-practice planning clusters spanning 18 weeks. Each cluster states its focus, key activities and a milestone that must be reached before the next cluster begins.

Weeks 1-3

Cluster 1 - Onboarding & Foundations

Settle in, set up the working environment, and agree the detailed plan and success criteria with the academic and industrial supervisors.

Key activities
  • Onboarding at Graha International: tooling, data-governance and NDA briefing.
  • Familiarisation with digital-twin concepts, vehicle subsystems and existing Graha assets.
  • Set up a reproducible environment: version control, experiment tracking and a containerised workspace.
  • Refine scope, success criteria and the detailed 18-week work plan with the supervisor.
Milestone, Approved internship work plan and a running, reproducible development environment.
Weeks 4-6

Cluster 2 - Literature Review & Requirements

Build the scientific foundation through a structured literature review and a precise requirements and evaluation specification.

Key activities
  • Structured literature review on digital twins, data fusion and hybrid modelling.
  • Survey of digital-twin reference architectures and simulation tooling.
  • Stakeholder and requirements analysis; definition of the core use cases and KPIs.
  • Draft the conceptual approach and the evaluation methodology with metrics and baselines.
Milestone, Literature-review report and an agreed requirements and evaluation plan.
Weeks 7-9

Cluster 3 - Data Engineering & System Architecture

Prepare the data assets and design the digital-twin platform architecture.

Key activities
  • Acquire, profile and clean the sensor telemetry for the chosen subsystem.
  • Select the twin scope and fidelity; define the state representation.
  • Design the platform architecture: ingestion, twin state, modelling, simulation and view layers.
  • Specify the synchronisation strategy and the interfaces between components.
Milestone, Architecture design document and a prepared, documented telemetry dataset.
Weeks 10-13

Cluster 4 - Implementation & Modelling

Implement the platform and the physics- and data-driven twin models.

Key activities
  • Implement the real-time data-fusion pipeline that updates the twin state.
  • Develop the physics-based and data-driven models and combine them into a hybrid twin.
  • Implement the simulation and what-if analysis engine.
  • Build a monitoring dashboard that visualises the twin and its predictions.
Milestone, Working Digital Twin prototype covering the core monitoring-and-simulation use case.
Weeks 14-16

Cluster 5 - Evaluation, Validation & Hardening

Evaluate, validate and harden the prototype against measured behaviour.

Key activities
  • Define and run experiments on twin fidelity, synchronisation latency and prediction error.
  • Validate simulated behaviour against measured telemetry.
  • Assess robustness to missing or noisy data; check reproducibility of results.
  • Iterate on the models and the synchronisation logic based on the findings.
Milestone, Evaluation report with quantitative results and a validated, hardened prototype.
Weeks 17-18

Cluster 6 - Documentation, Thesis & Final Defence

Consolidate the documentation, draft the thesis material and present the results.

Key activities
  • Consolidate code, documentation and reproducibility instructions.
  • Write the thesis-ready report covering method, results and limitations.
  • Prepare and deliver the final presentation and a live demo.
  • Hand over the platform, datasets and the backlog of future work to Graha.
Milestone, Final thesis-ready report, final presentation and a complete handover package.

Expected Outcomes

Project Timeline (Gantt Chart)

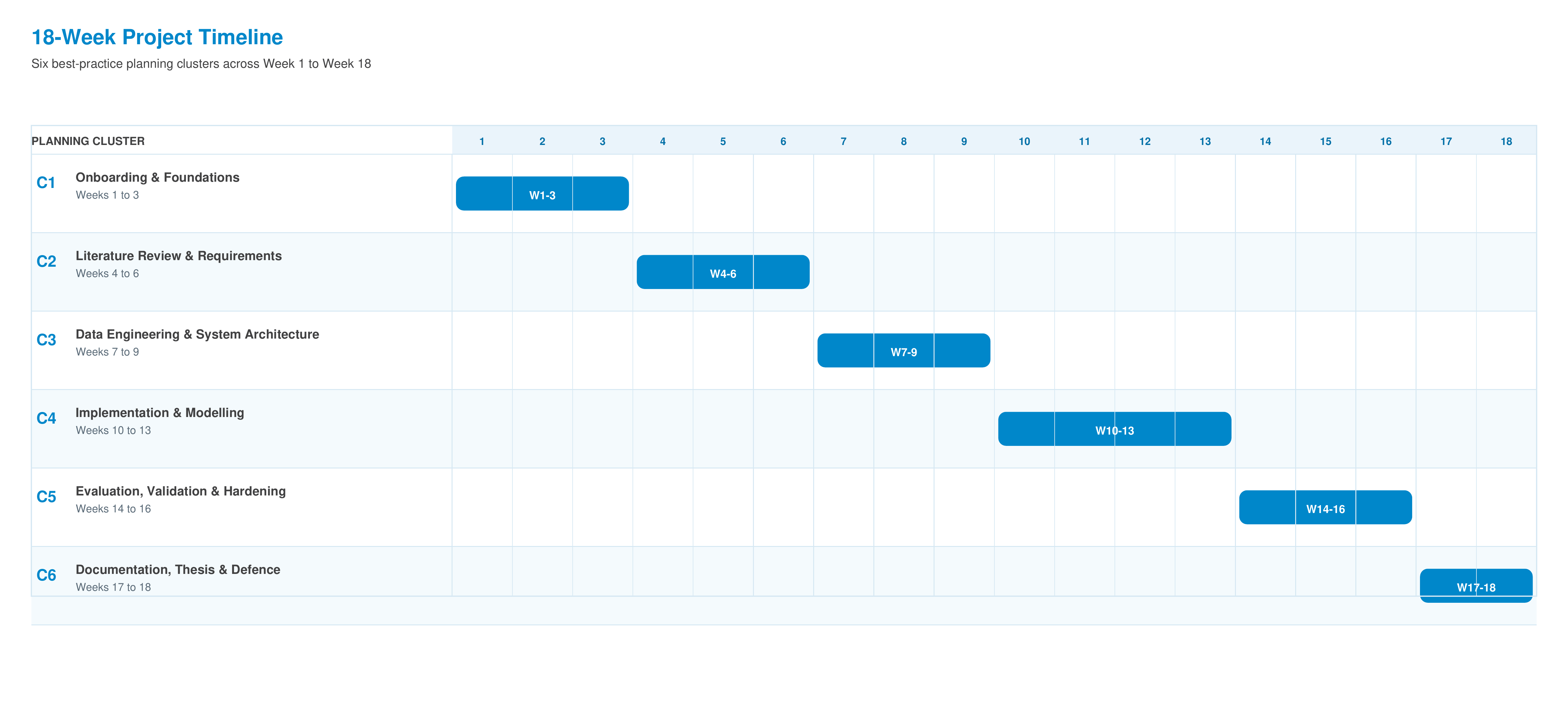

The 18-week plan visualised as a Gantt chart. Each of the six planning clusters is shown against its span across Week 1 to Week 18.

18-week project timeline Gantt chart
